The Production Cockpit is the central dashboard for monitoring shop-floor activity in the Beas Web Client. It consolidates production status, performance KPIs, resource availability, active work orders, and material shortages into a single screen so production planners and supervisors can spot bottlenecks and act in seconds.

This cockpit is a complete redesign of the existing desktop cockpit with visual improvements, two new KPI cards (Schedule Adherence and Production Efficiency), and direct navigation to Material Requirements and Inventory History.

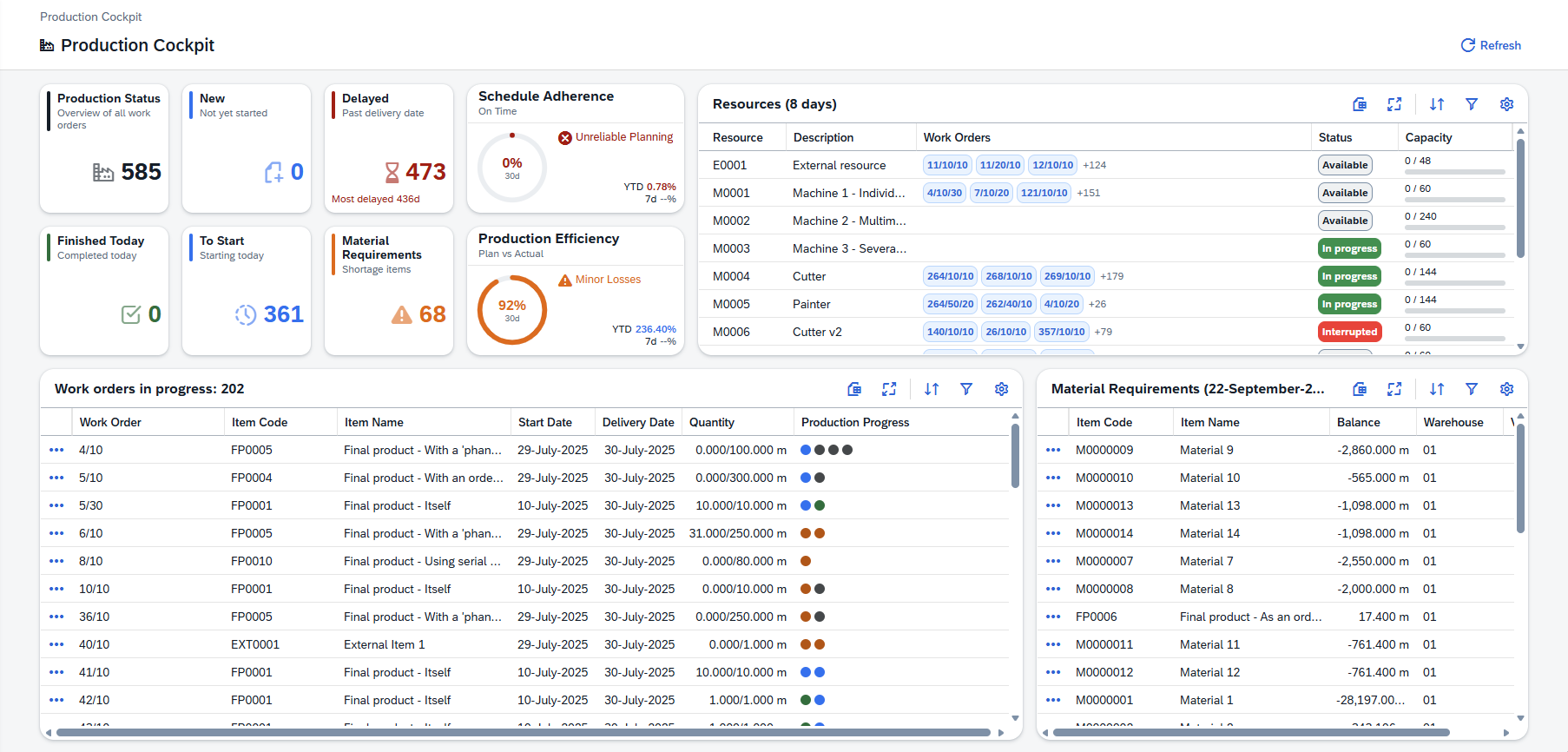

Production Cockpit

Production Status​

Six tiles give an immediate snapshot of the work in the shop floor. Each tile shows a single number so it can be read at a glance.

TileDescription
Total OrdersThe number under the filter represents the count of all work orders.
NewWork orders that have been created but have not been started yet. Use it to see the backlog waiting to enter production.
DelayedWork orders with delivery dates already in the past. The footer "Most delayed: X days" highlights the worst case so you can prioritize recovery.
Finished TodayWork orders completed during the current day. A live indicator of today's output, useful for end-of-shift reviews.
To StartWork orders scheduled to start today. Helps confirm that planned starts are actually being released to production.
Material RequirementsNumber of items currently in shortage. Click the tile to jump straight to the full Material Requirements view.

Performance KPIs​

Two gauges score how well production is performing. The main value covers the last 30 days; below each gauge the YTD (year to date) and last 7 days values are shown so you can compare short-term against long-term trends.

Schedule Adherence — percentage of work orders completed on or before their planned finish date. Higher is better.

RangeLabelIndicator
≥ 95 %ExcellentInformative
≥ 85 %GoodPositive
≥ 70 %Execution IssuesCritical
< 70 %Unreliable PlanningNegative

Production Efficiency — compares planned vs. actual time and material consumption. Higher efficiency means less time and fewer materials were used than originally planned.

RangeLabelIndicator
≥ 100 %Above StandardInformative
≥ 95 %ExpectedPositive
≥ 85 %Minor LossesCritical
< 85 %InefficienciesNegative

Resources​

Shows every production resource together with its workload for the period indicated in the card title (Resources (N days)). The number of days comes from the Beas configuration, so it can vary from one company to another. Use this section to spot resources that are overbooked or sitting idle.

ColumnDescription
ResourceResource code.
DescriptionResource name.
Work OrdersWork orders scheduled on the resource within the period. A +N badge appears when there are more work orders than fit in the cell.
StatusCurrent state of the resource: Available, In progress or Interrupted. Hover the chip for an extended tool tip:
• In progress — employee, start date, work order operation and item being produced.
• Interrupted — employee, start date, interruption code and reason.
• Available — if a next operation is already scheduled, the tooltip shows the upcoming work order operation and item.
CapacityUsed vs. total capacity for the period, with a colour-coded bar: < 70 %, ≥ 70 %, ≥ 90 %.

Work orders in progress​

Lists every work order that is currently active. The total count is shown in the card title (e.g. Work orders in progress: 202) so you always know how many are running.

ColumnDescription
Work OrderWork order ID and position (WO/Pos) that uniquely identify the order.
Item Code / Item NameItem being produced by the work order.
Start Date / Delivery DatePlanned start date and the date by which the work order is expected to be delivered.
QuantityQuantity already produced and the total quantity planned, separated by a slash.
Unit of MeasureUnit of measure used for the quantity column.
Operation ProgressOne colored circle per operation in the work order, showing the status of each step: Not started, Already started, In progress, Completed. The tool tip on each circle is headed by WO / Position / Operation and the status, and adds:
• Not started — only the header.
• Already started — list of time receipts already booked (employee, quantity made, start date). If there are more than three, the count of extra receipts is shown.
• In progress — the employee currently working, the resource and the start date of the open receipt.
• Completed — list of time receipts that closed the operation (employee, quantity made, start date), with the extra-receipt count when needed.

Row action: click the row's actions menu (…) and choose Material Requirements to open the Material Requirements view filtered to that work order.

Material requirements​

Lists items currently in shortage according to the latest material requirements calculation. The card title shows the date and time of that calculation (e.g. Material Requirements (09-22-25 05:24 PM)) so you know how fresh the data is.

ColumnDescription
Item CodeCode of the item that is missing.
Item NameItem description.
Unit of MeasureUnit of measure used in the balance column.
BalanceNet availability after demand has been deducted. Negative values indicate the size of the shortage.
WarehouseWarehouse to which the requirement belongs.
VersionCalculation scenario (when several scenarios coexist).

Row action: click the row's actions menu (…) and choose Inventory History to open the Inventory History view for the item — the fastest way to investigate where the shortage comes from.

No calculation available

If the material requirements calculation has never been run, the grid is replaced by a message indicating that no calculation date is available.

Refreshing data​

The cockpit does not auto-refresh. Use the Refresh button in the top-right corner of the page header to reload all tiles, KPIs and grids.

Tips​

  • Personalize grids: each grid stores its column visibility, order, sort and filters per user. Use the Settings icon to show or hide columns — your selection is remembered the next time you open the cockpit.
  • Full-screen mode: use the full-screen icon in any grid to expand it — great for shop-floor displays.
  • Quick navigation: the Material Requirements tile and the row actions in the bottom grids let you jump to the related view without losing the cockpit context — use the browser back navigation to return.
  • Tool tips everywhere: hover the resource Status chips and the work order Operation Progress circles for extended details about each item.
