Work Order Routing

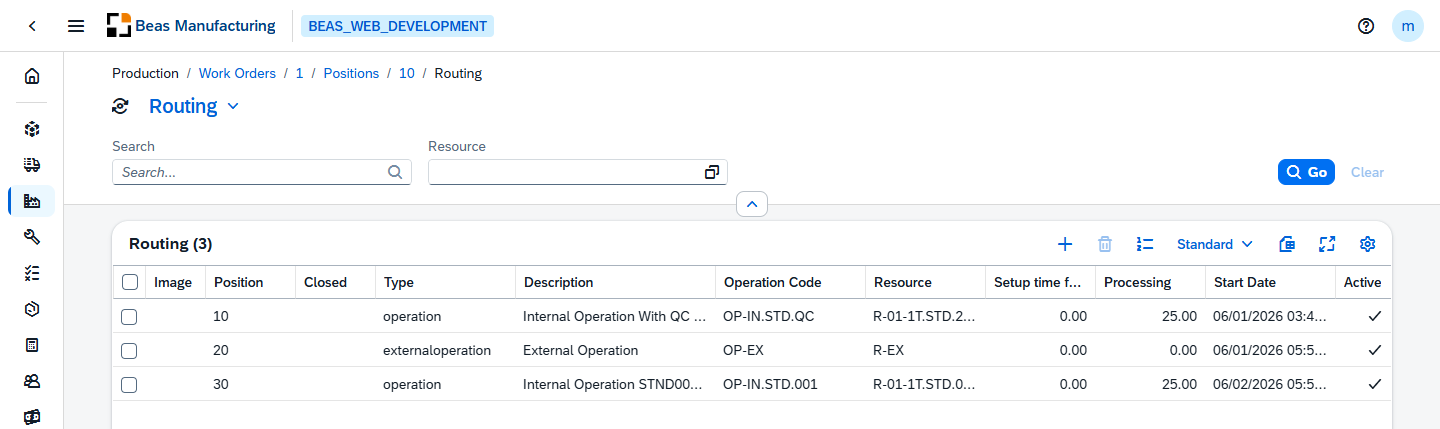

Press Routing in the WO Positions Detail header to see the operations assigned to this position. Each row is one work step in the production sequence, in the order it is carried out.
The list is the work order's own copy of the routing. It is exploded from the item's Routing when the position is created, and can be changed afterwards without affecting the item's master data.

Actions
One action is specific to this list; the rest of the tool bar is the standard one.
| Action | Icon | Description |
|---|---|---|
| Renumber | Renumbers the whole list in the order it is in, closing the gaps left by deleted or inserted steps. Asks to confirm first, and is refused on a closed position. |
Default Columns
| Field | Description |
|---|---|
| Image | Image or icon saved for the operation. |
| Position | The operation's place in the production sequence. |
| Closed | When enabled, the operation is closed and no longer confirmed. |
| Type | The operation type, e.g. "Internal" or "External". |
| Description | The long description of the operation. |
| Operation Code | The code of the operation as defined in the operation catalog. |
| Resource | The resource — machine or work center — that carries out the operation. See Resources. |
| Setup Time | Planned time needed to set up before the operation can run. |
| Run Time | Planned time needed to actually run the operation. |
| Start Date | The planned start date and time of the operation. |
| Active | When the operation is active it takes part in scheduling. |
note
The time column labels follow your time-type configuration. Setup Time, Run Time, Rework and Quality Control are the default names; a system configured with its own time types shows those names instead.
Additional Columns
| Column | Description |
|---|---|
| Position ID | Internal identifier of the operation within the position. |
| Setup Time Capacity | Setup time that counts against the resource's capacity. |
| Rework | Planned rework time. |
| Quality Control | Time reserved for quality control. |
| Use Factor | Factor applied to the operation's time. |
| Work Steps | Number of work steps in the operation. |
| Idle Time | Idle time after the operation. |
| Overlap Limit | Overlap with the next operation. |
| Number of Payslips | Number of payslips for the operation. |
| Quantity per Time | Output quantity produced per time unit. |
| Time Unit | Time base the quantity per time refers to. |
| Resource Allocation | How the resource is allocated (Simple, Quantity, Percent). |
| Allocation Quantity | Quantity used for the resource allocation. |
| End Date | The planned end date and time of the operation. |
| Total Start Date | Start of the operation including transfer and wait time. |
| Total End Date | End of the operation including transfer and wait time. |
| Transfer Start | Start of the transfer time before the operation. |
| Transfer End | End of the transfer time before the operation. |
| Wait Start | Start of the wait time after the operation. |
| Wait End | End of the wait time after the operation. |
| Actual Time | The time actually recorded on the operation. |
| Milestone | Marks the operation as a milestone. |
| Milestone Date | The date the milestone is reached. |
| QC Inspection Plan | The linked quality-control inspection plan. |
| Cost Center | The cost center the operation is booked to. |
| Color | Colour assigned to the operation. |
| Instructions | Work instructions for the operation. |
| Attachment 1 … Attachment 3 | The files attached to the operation. |
| Supplier | The supplier carrying out an external operation. |
| Item | The subcontracting item used for an external operation. |
| Price per unit | Subcontracting price per unit. |
| Price factor | Factor the subcontracting price refers to. |
| Currency | Currency of the subcontracting price. |
| Minimum price | Minimum subcontracting price. |
| Shipping price | Shipping price for the external operation. |
| Shipment lot size | Lot size the shipping price refers to. |
| Purchase Order Warehouse | Warehouse used for the subcontracting purchase order. |
| Original Position | The operation this one was copied from. |
| Time Recording | Whether time recording is enabled for the operation. |
| Time Recording Date | The time-recording date. |
| Time Recording Mandatory | Requires a time receipt before the operation can be completed. |
| Module | The module the operation belongs to. |
| Wage Group | The wage group of the operation. |
| Processing Type | The processing type of the operation. |
| Multi-Machine Requirement | Number of resources the operation requires at once. |
| Time Type | The time type of the operation. |
| Time Type ID | Identifier of the time type. |
| Subcontract Flag | Marks the operation as subcontracted. |
| Phantom Assembly Group | The phantom assembly group the operation belongs to. |
| Phantom Assembly Group Position | The operation's position inside the phantom assembly group. |
| Phantom Assembly Group Quantity | Quantity contributed by the phantom assembly group. |
| Scrap Factor | Scrap expressed as a factor. |
| Marginal Cost Rate | Marginal cost rate per minute. |
| Full Cost Rate | Full cost rate per minute. |
